PROJECT EXPERIENCE / WEST HOLLYWOOD

One project.
Two agencies.
One coordinated plan.

At 454 N Robertson Blvd., Public Ready helped align traffic-control planning, West Hollywood street permits, and Beverly Hills Water requirements for domestic and fire-water service work.

Request a project estimate

A documented project experience from scope clarification through service activation.

PROJECT CASE STUDY / 2:14

West Hollywood Water-Service Coordination | 454 N Robertson | Public Ready

One project, two agencies: traffic-control planning, separate street permits, City and private-contractor work boundaries, and follow-through on fire-service activation.

Watch on YouTube (opens in a new tab)
PROJECT ADDRESS454 N Robertson Blvd.

West Hollywood, California

UTILITY SCOPEDomestic + fire service

2-inch domestic / 4-inch fire

AGENCIES INVOLVEDWest Hollywood + Beverly Hills Water

Street permits and water-service requirements

THE COORDINATION CHALLENGE

The address was only the starting point.

The property was in West Hollywood, while Beverly Hills Water handled the water-service requirements. The project team needed to clarify both agencies’ roles before aligning construction scopes and dates.

PUBLIC RIGHT-OF-WAY

West Hollywood

Street permitting needed to match the City-led utility work and the separate private-contractor work.

Explore West Hollywood support

WATER-SERVICE REQUIREMENTS

Beverly Hills Water

Written clarification established the utility installation boundary and responsibilities for the shared trench.

Explore agency coordination

THE WORK BOUNDARY / CONFIRMED FOR THIS PROJECT

Confirm where City work ends and private work begins.

Beverly Hills confirmed that City crews would install from the water main to upstream of the meters. The private contractor would connect downstream toward the project.

Shared-trench requirements also affected the installation approach. Those details needed to be resolved before assuming one contractor could perform the entire scope.

WHY THE CITY PERFORMED PART OF THE WORK

The shared trench changed who performed the installation.

Beverly Hills cited Side Letter Agreement 92-21, Item 4. Its mixed-installation provision assigns the installation to City Water System Workers when service laterals of two inches or smaller and larger than two inches share the same trench. This project combined a two-inch domestic service and a four-inch fire service in a shared trench.

The 2021 agreement distinguishes between smaller service laterals, larger service laterals, and mixed installations. Under Item 4(c), mixed sizes in the same trench are installed by City Water System Workers. Separate trenches follow the size-based division in Items 4(a) and 4(b).

Public Ready obtained written clarification of the City and private-contractor boundaries so the project team could align the installation scopes, permits, and construction sequence.

For your project: confirm the utility’s work-assignment requirements before finalizing contractor scope or scheduling the work. The responsibilities described here apply to this project.

PUBLIC READY’S ROLE

Keep the plans, permits, and people aligned.

Public Ready’s support connected the documentation with the work sequence and continued as project needs changed.

01

Traffic-control planning

Coordinate the work footprint, public access, and construction sequence in the plan package.

Explore this service
02

Permit and agency coordination

Align each work phase with its responsible team, permit scope, authorized dates, and agency comments.

Explore this service
03

Parking and access arrangements

Coordinate temporary no-parking needs and requests to clear street fixtures from the utility work area.

Explore this service
04

Project follow-through

Track schedule changes, restoration responsibilities, service activation, and remaining project actions.

Explore this service

Two permits. Distinct work scopes.

Matching each permit to the responsible team helped coordinate work dates, parking arrangements, and street-fixture clearance.

ENCR26-0391

Beverly Hills Water utility work within West Hollywood

ENCR25-1031

Private-contractor work; later revised for an extension and additional scope

DOCUMENTED MILESTONES

Follow-through beyond the initial permit.

Coordination continued through permit changes, restoration discussions, and fire-service activation.

  1. June 1, 2026

    Work boundaries confirmed

    Beverly Hills confirmed the City and private-contractor installation boundaries in writing.

  2. August 14, 2026

    Permit scope and dates updated

    West Hollywood confirmed the private-work permit revision for an extension and additional scope.

  3. September 4, 2026

    Fire service turned on

    Beverly Hills confirmed fire-service activation and delivery of the replacement water-meter box and lid.

CONFIRMED OUTCOME / SEPTEMBER 4, 2026

Fire service turned on.
Replacement meter box and lid delivered.

On September 4, 2026, Beverly Hills staff confirmed that the fire service was turned on and a replacement water-meter box and lid were delivered.

Project summary based on Public Ready’s project correspondence and agency confirmations. The thumbnail is a conceptual illustration. This account does not establish a final municipal inspection or a rule for other projects.

View a redacted West Hollywood utility plan example

FROM THE PROJECT SITE

The work, seen at street level.

Actual photographs supplied by Public Ready from the Robertson Boulevard project. These views show the frontage and work areas during different stages of coordination.

Red-and-white temporary no-parking sign posted on a parking meter along the sidewalk at 454 N Robertson Blvd.
PUBLIC READYPROJECT PHOTO

Temporary No Parking

Temporary no-parking sign at the project frontage.

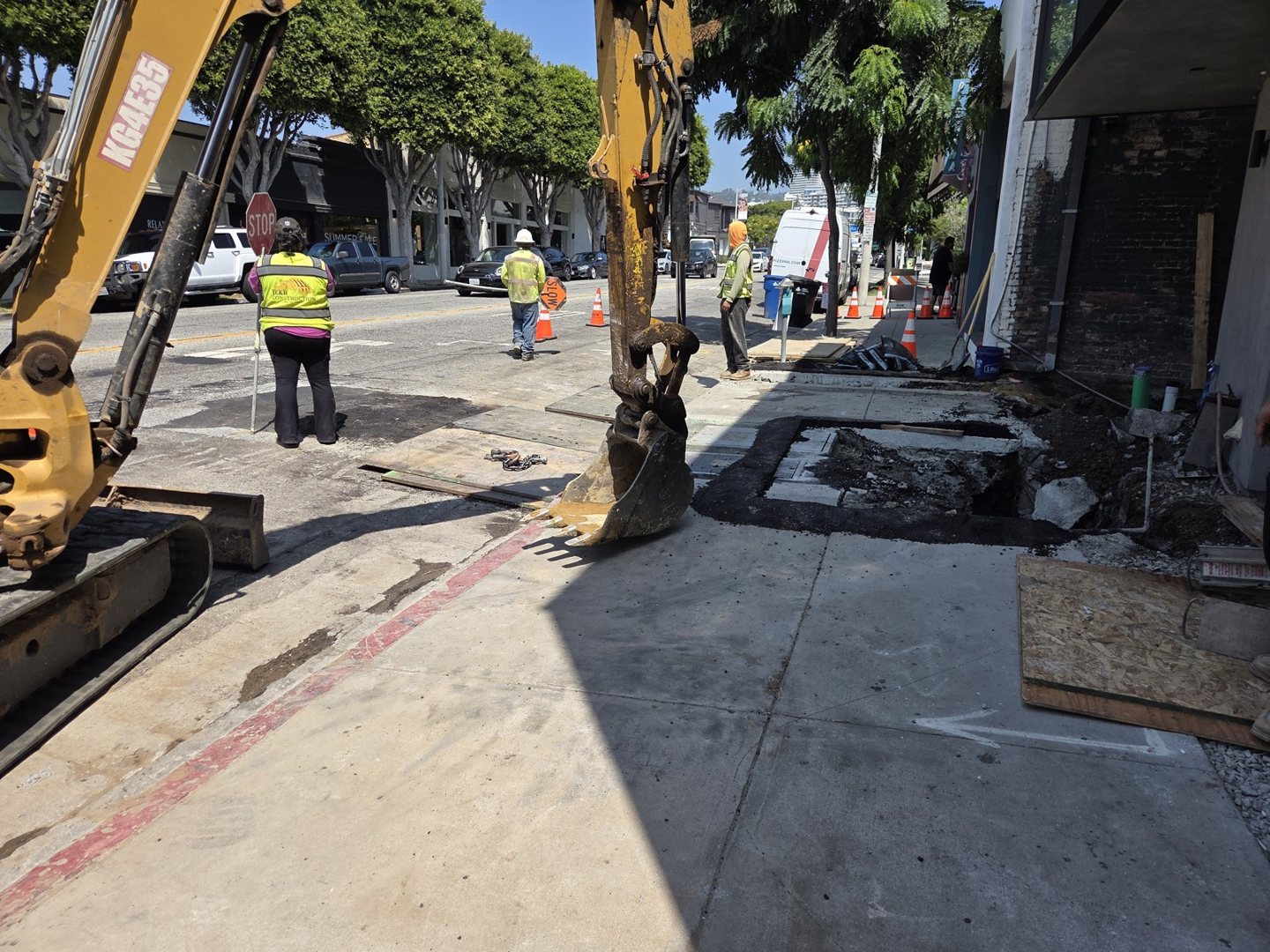

Excavator and workers beside the curb and sidewalk at the Robertson Boulevard project frontage.
PUBLIC READYPROJECT PHOTO

Excavation at the frontage

Excavation equipment and crews working along the curb and sidewalk.

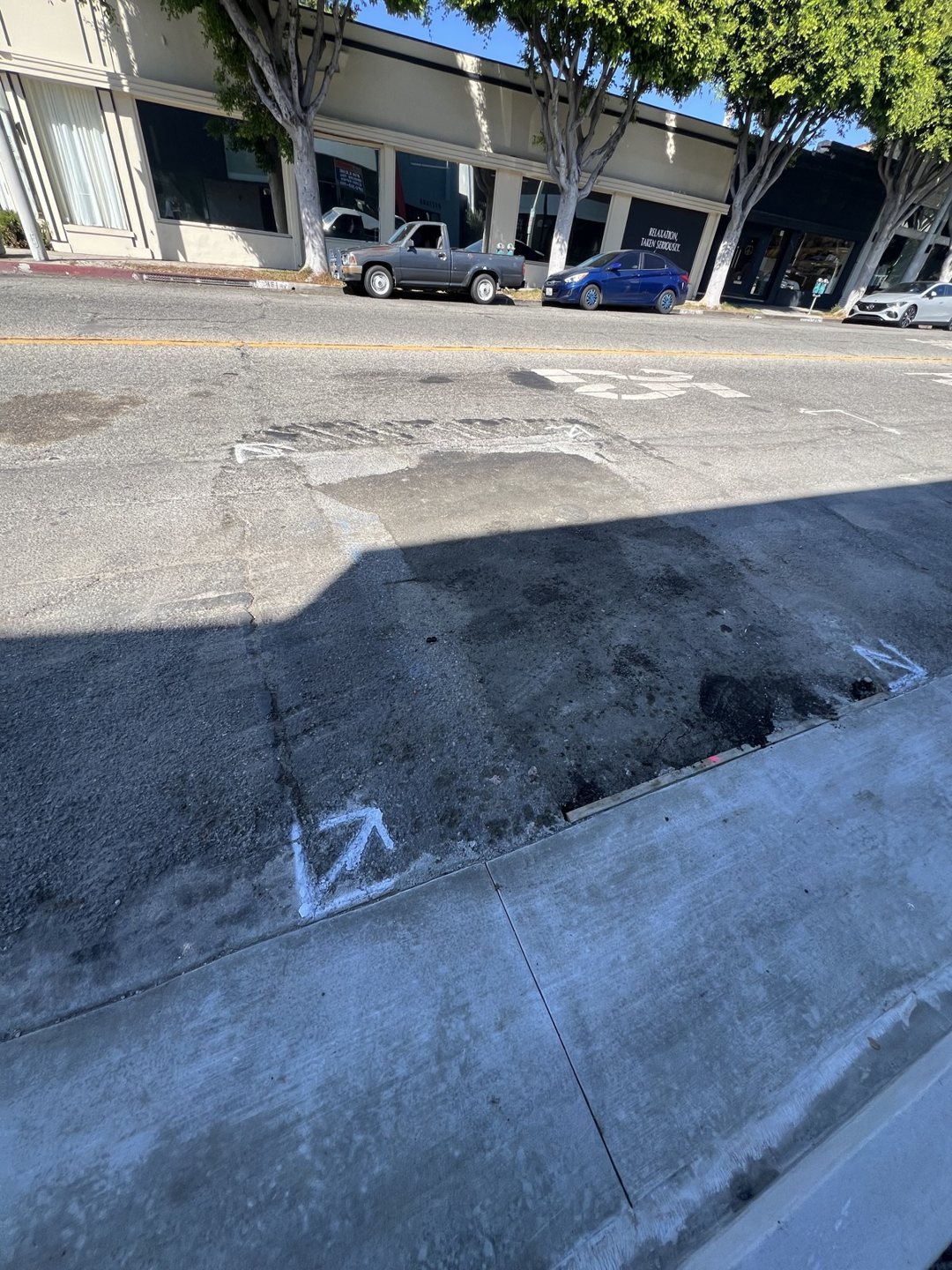

Asphalt patch and utility markings in the roadway beside the project sidewalk.
PUBLIC READYPROJECT PHOTO

Roadway work area

Roadway patching and utility markings beside the project frontage.

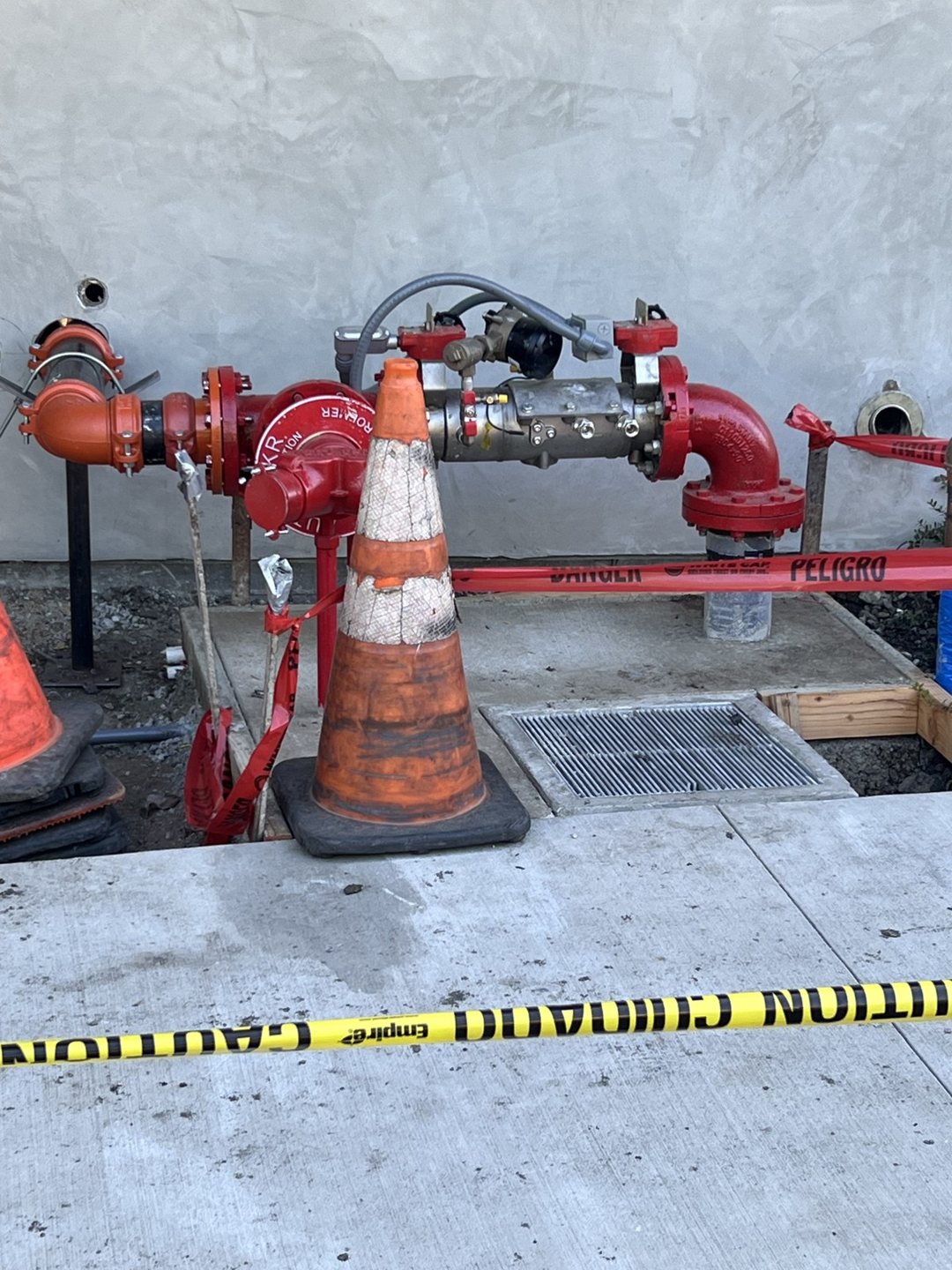

Red piping and valve assembly beside the building, with cones and caution tape marking the work area.
PUBLIC READYPROJECT PHOTO

Service piping and valves

Red service piping and valves beside the building, with the adjacent work area visible.

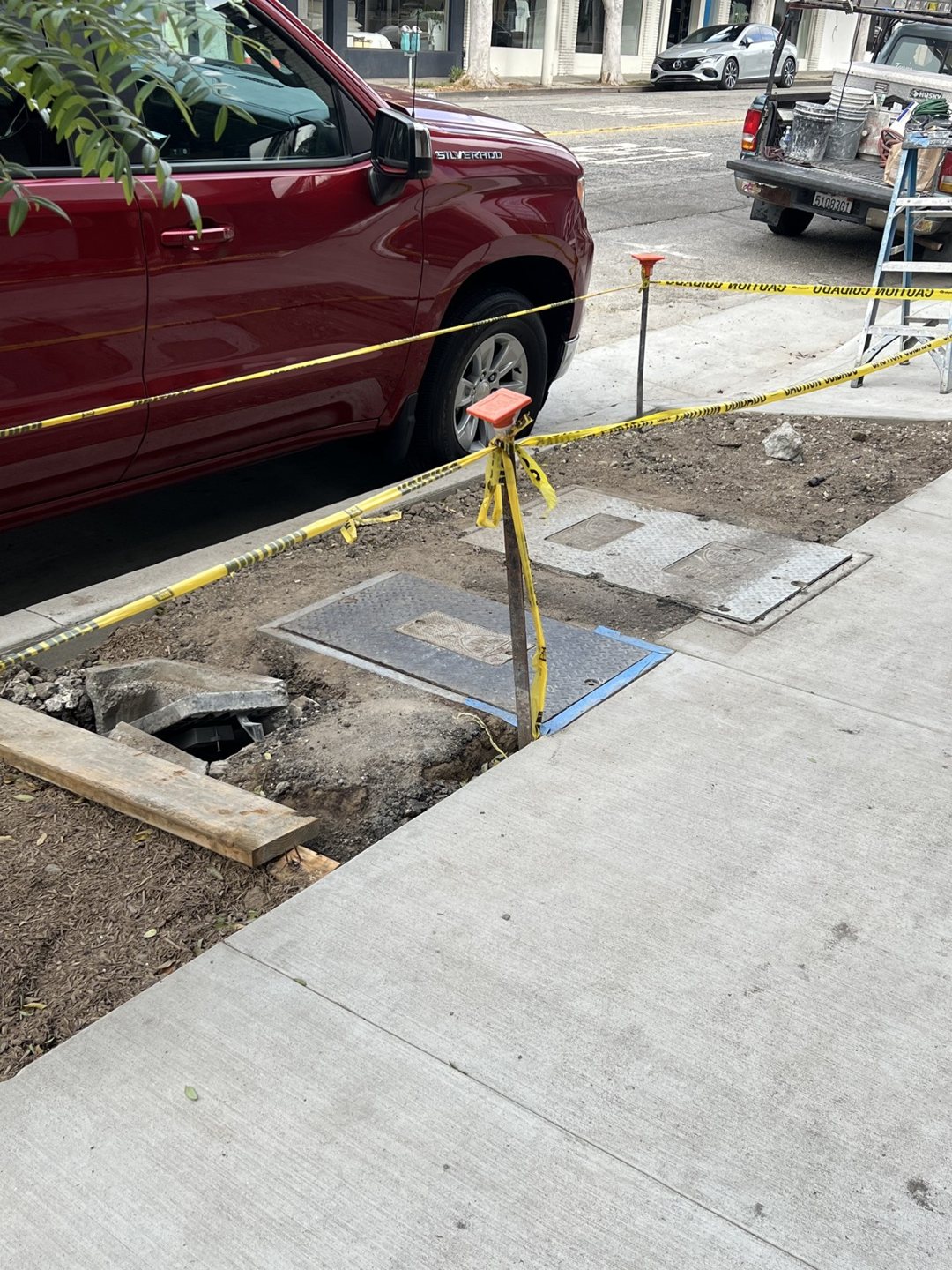

Meter covers and open work areas beside the sidewalk, marked with caution tape.
PUBLIC READYPROJECT PHOTO

Meter work at the sidewalk

Meter covers and open work areas at the sidewalk during project follow-through.

Photographs document visible site conditions at different stages. The confirmed service-activation outcome above is based on agency correspondence; the photographs do not establish a final municipal inspection. The Public Ready badge identifies the brand.

PRACTICAL QUESTIONS

What should your project team confirm?

Can the water provider differ from the city where the property is located?

Yes. This project was in West Hollywood and involved Beverly Hills Water. Confirm both the street authority and utility provider for your project address.

Can a private contractor perform the entire water-service installation?

Confirm the boundaries with the utility. On this project, Beverly Hills specified the City installation boundary and shared-trench requirements; the private contractor’s downstream work remained separate. Your project may differ.

Does a traffic-control plan replace an encroachment permit?

The plan and permit serve different purposes. Coordinate the required drawings, work scope, and authorized dates with the reviewing agency before fieldwork.

When should Public Ready be involved?

Share your plans and agency comments while the scope and schedule are being developed. Public Ready can assess the planning, permit support, and project coordination services appropriate for your estimate.

YOUR NEXT PROJECT

Planning utility work in the street or sidewalk?

Send your project address, available plans, and agency comments. Public Ready can review the planning and coordination scope for your estimate.

Request a project estimate

This is a historical project case study. Responsibilities and requirements must be confirmed for each project and agency.
